Linking Tasks and Dependencies
How to link tasks in ProjectLibre using the Critical Path Method, the four dependency types, and lag and lead.
Watch: Enter Tasks and Link Video
ProjectLibre uses the Critical Path Methodology (CPM) to calculate your schedule. Linking tasks ensures that if a predecessor’s timeline shifts, the successor’s dates adjust automatically.
To test the structure and discipline of that CPM model, use Project Audit (DCMA Schedule Quality Audit).
Three Ways to Link Tasks
-
Gantt Chart Drag-and-Drop: Click and hold a predecessor task bar, then drag the connector line to the successor task bar.
-
The Predecessor Column: Type the ID number of the predecessor directly into the “Predecessor” column in the spreadsheet. For multiple links, use a semicolon (e.g.,
3;4). -
Network Diagram: Click and drag between task nodes (boxes) to create a logic flow.
Relationship Types & Offsets
Click on any link line (the arrow) to edit the relationship type. The Edit Task Dependency dialog offers FS / FF / SS / SF plus Lag (Days) — for example Start-to-Start with a 2-day lag (SS+2d), as shown in the 2.0 preview.
| Code | Type | Meaning |
|---|---|---|
| FS | Finish-to-Start | (Default) Successor starts when predecessor finishes. |
| SS | Start-to-Start | Successor starts when predecessor starts. |
| FF | Finish-to-Finish | Successor finishes when predecessor finishes. |
| SF | Start-to-Finish | Successor finishes when predecessor starts (Rare). |
Using Lag and Lead
Two ways to offset a link: lag and lead:
-
Lag (Positive):
FS+2dadds a 2-day delay after the predecessor finishes. -
Lead (Negative):
FS-1dallows the successor to start 1 day before the predecessor finishes.
Example: Project Precedence Logic
The following table shows how data in the Predecessor column builds a logical sequence:

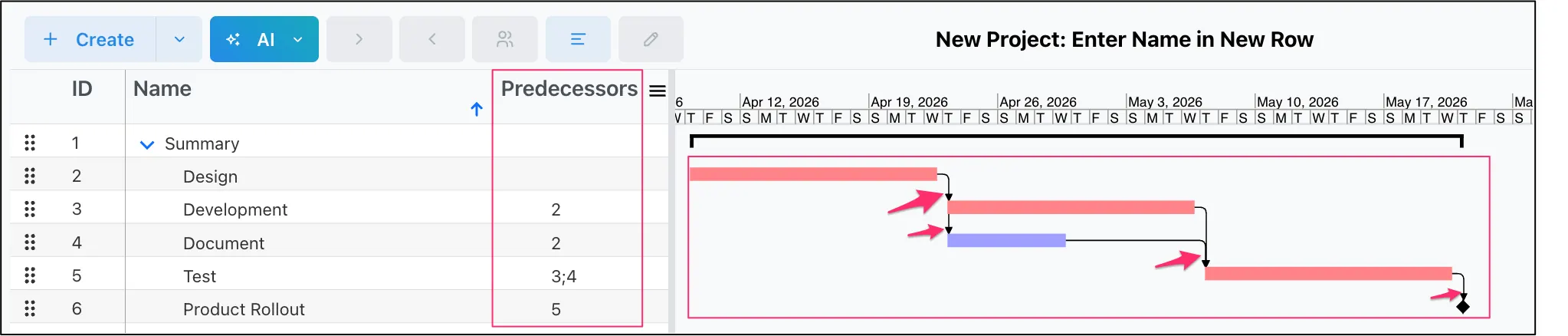

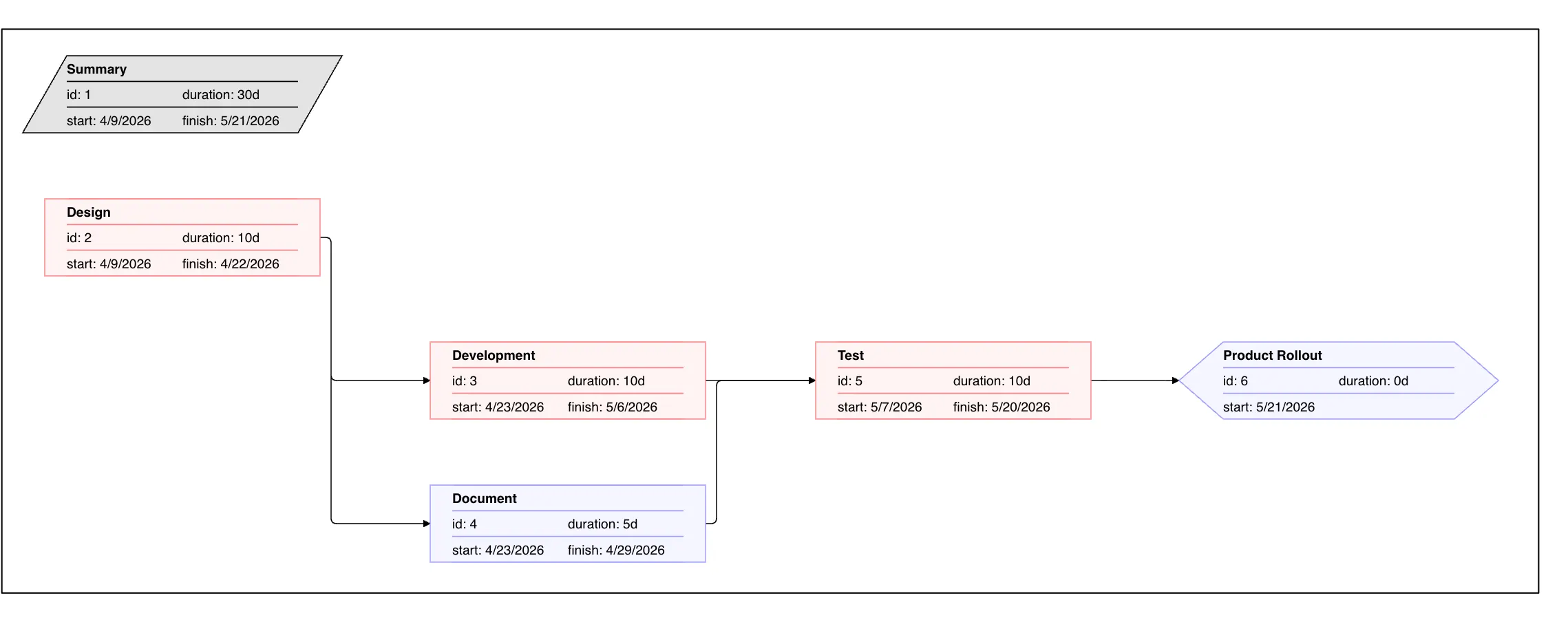

| ID | Task Name | Predecessor | Relationship Logic |
|---|---|---|---|
| 1 | Project Summary | N/A | Automatically rolls up subtask data. |
| 2 | Design | — | The project start point. |
| 3 | Development | 2 | Starts after Design finishes (FS). |
| 4 | Document | 2 | Runs in parallel with Development. |
| 5 | Test | 3;4 | Starts only when both Dev and Doc are complete. |
| 6 | Product Rollout | 5 | Final Milestone after successful testing. |


Dependencies set the logic network. Next, assign people (Assigning Resources), then use Scheduling for baselines, calendars, constraints, task types, and tracking — before Resource Leveling resolves overallocation.
